Serving Greater Temple

Concrete Driveway

New concrete driveways, aprons and drive approaches in Temple, TX, detailed to the soil under them and permitted through the city right-of-way.

Temple Elite Concrete builds concrete driveways in Temple, TX, serving surrounding cities including Belton, Nolanville, Harker Heights, Killeen and McGregor, and after 20+ years here the single most useful thing we bring to a driveway is knowing what is under it before anyone quotes it. A driveway is the largest piece of concrete most properties will ever own, and it is the one most exposed to the ground it sits on.

A new driveway is really two projects joined at the property line. Everything on your lot is yours to specify: width, thickness, reinforcement, joint layout, finish and color. Everything from the property line out to the street is the drive approach, and that half is regulated, bonded, permitted and inspected before a single truck discharges.

Both halves are decided by the same soil. Roughly 41% of the mapped ground under this city is deep smectitic clay that swells and shrinks with moisture, while about 32% is shallow soil sitting on chalk, where a trench can hit rock rather than dirt. A driveway detailed for one of those and built on the other is a driveway that cracks early, which is why we establish the soil before pricing anything.

Building a Concrete Driveway That Holds Up Here

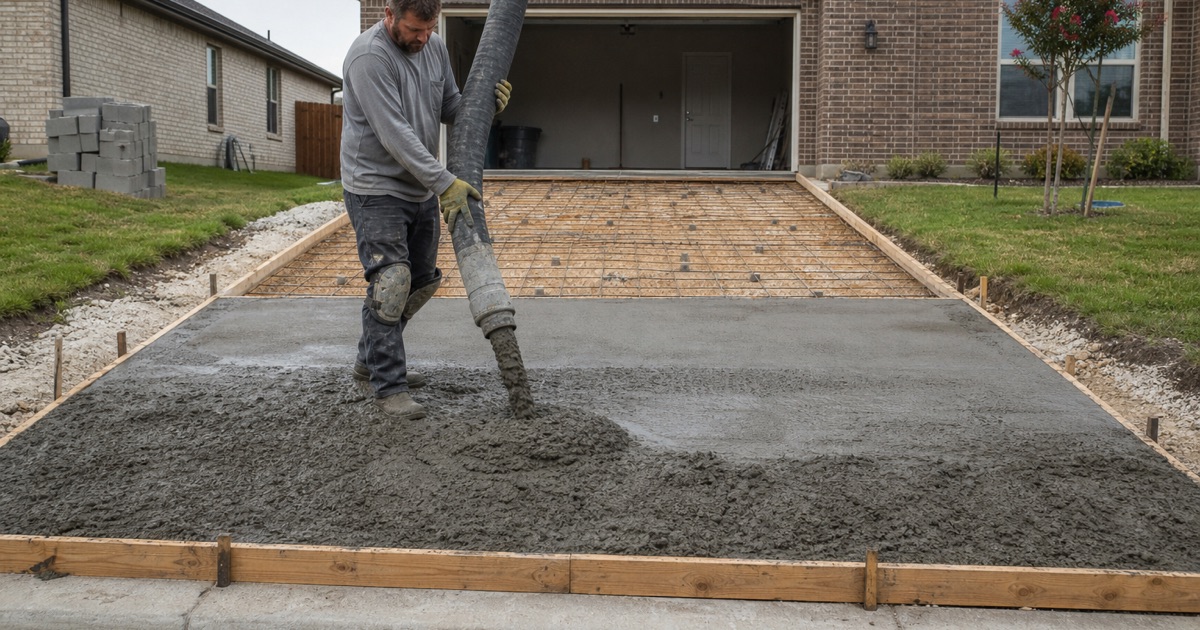

Ready mix being placed into formed driveway bays in Temple from a pump hose, the struck-off area behind and reinforcing on chairs ahead.

Subgrade Preparation and Base Course

The subgrade is the part nobody sees and the part that decides the outcome. We strip organics and soft material, bring the exposed soil to uniform moisture and density rather than compacting a dry crust over a soft layer, and place a base course where the native material will not serve on its own. Uniformity matters more than raw strength. A driveway sitting half on compacted base and half on undisturbed clay will crack at the transition regardless of how thick it is, so the goal of subgrade compaction is to make the whole footprint behave the same way rather than to make one part of it very strong.

Thickness, Reinforcement and Joint Layout

Thickness follows the heaviest thing that will use the drive, not the family car. Reinforcement is chosen the same way: welded wire reinforcement or rebar on chairs where loads and soil movement justify it, fiber mesh where the concern is shrinkage rather than structure, and dowel baskets where a slab has to transfer load across a joint.

Joints are the part homeowners underestimate. Concrete will crack, and control joint spacing, commonly 24 to 36 times the slab thickness, decides whether it cracks along a sawcut you chose or across the middle of a panel you did not. Isolation joints keep the drive from binding against the garage slab and the approach.

Concrete Mix, Placement and the Discharge Clock

Mix design covers compressive strength, slump, air entrainment, water cement ratio and aggregate gradation, and the last two are where a good pour is most often given away on site by adding water to make placement easier. We place at the specified slump and use admixtures rather than a hose to buy workability. Heat compresses the whole operation. Once the concrete itself reaches 90 degrees the state highway standard allows 45 minutes from batching to begin discharging, or 75 minutes with a Type B or D admixture, so summer pours are sized, staged and staffed to finish inside that window rather than started and hoped through.

The Drive Approach and City Right-of-Way

Drive Approach Permits and Bonds

Before anyone removes, alters or constructs a curb, approach or gutter on public property, the city requires an approach permit, and it is unlawful to pour concrete or begin a drive approach without that approved permit displayed on site. The city also runs two bonds: one before working in streets and public ways, and a separate one for drive approach construction. We pull the permit, post it, and carry both bonds. Because applications get 10 business days for city review and comment before a permit can be issued, that window goes into the schedule we hand you at the start rather than surfacing after you have cleared the driveway and moved the cars.

Residential Approach Dimensions and Corner Clearance

The approach is dimensioned by the city rather than by preference. Residential approaches carry a minimum corner clearance of 15 feet and a minimum curb return radius of two and one-half feet, joint access curb cuts are encouraged where lots are less than 50 feet wide, and a new residential approach onto an arterial is prohibited unless the lot was platted fronting that street or a variance is approved. Those standards are adopted as advisory guidelines, which means the Director of Public Works may permit or require a deviation and must write the justification on the face of the permit. That flexibility exists, but it is exercised by the city rather than assumed by the contractor.

The Pre-Pour Inspection and the One Year Warranty

Once the approach is formed and ready for concrete, the contractor has to notify the inspections department, and an inspector then has one working day to approve or disapprove the preparation. Requests placed after 4:00 p.m. move to the next business day, which is a real constraint on a same-week pour. The obligation does not end at final payment. A drive approach has to be kept free from structural defects for one year from the date of final approval and acceptance by the city, at no cost to the owner, with defective work corrected by the contractor or the bondsman.

Residential and Commercial Driveways

Driveway Widths, Turnarounds and RV Parking

Width is worth deciding deliberately, because widening later means a cold joint and a visible color difference. Backing space, a turnaround, a parking extension beside the drive or a pad for an RV all change the footprint, and an RV or trailer pad changes the thickness and reinforcement under that section rather than only its outline.

Residential Driveways, Aprons and Garage Transitions

On a house the driveway has to work with what it meets: the garage slab, any existing walk, the front step and the approach at the street. We set falls so water leaves the garage rather than pooling at the threshold, and we detail the joint at the garage as an isolation joint so the two slabs are free to move independently.

Commercial and Industrial Drive Approaches

Commercial and industrial frontage is governed by width and radius tables. Commercial two-way curb cuts run from a minimum of 24 feet to a maximum of 45 feet with a minimum edge clearance of 5 feet, industrial two-way curb cuts run from 35 feet to 50 feet with curb return radii of 15 to 50 feet, total curb cut may not exceed 50 percent of lot frontage, and an approach may meet a two-way roadway at an angle between 45 and 90 degrees.

Driveway Finishes, Sealing and Maintenance

Broom Finish, Exposed Aggregate and Salt Finish

A broom finish is the default on driveways because the texture provides traction when the surface is wet and it wears predictably. Exposed aggregate reveals the stone in the mix for a more textured, stain-tolerant surface. A salt finish gives a fine pitted texture that suits patios better than drives, where tires and shovels work the surface harder.

Stamped and Colored Concrete Driveways

Stamped patterns and integral color turn a driveway into the largest decorative element on the property, and the cost sits in the finish rather than in the base work, since excavation, reinforcement and thickness are identical either way. On a drive we favor patterns with shallower grout lines and colors that hold up in strong sun over the ones that photograph best on a sample board.

Sealing, Joint Care and Realistic Maintenance

A penetrating silane or siloxane sealer soaks in and changes the look very little; a film-forming acrylic deepens the color and adds sheen and is the one that needs periodic renewal. Either way the joints are what need attention: keeping control and expansion joints sealed stops water reaching the base, which is the mechanism behind most of the settlement we are later asked to lift.

  • 20+ Years in Central Texas
  • Bonded & City Registered
  • Free Written Estimates

Good to know

Frequently Asked Questions

How thick should a concrete driveway be in Temple?

Thickness is set by the heaviest vehicle that will use it and by what the slab sits on, not by a single default. A drive carrying only passenger cars over well-prepared base needs less than one that will hold an RV, a trailer or delivery trucks, and expansive clay pushes the answer up. We specify it after establishing the subgrade.

Do I need a permit to replace my existing driveway?

For the portion on your own property you need a flatwork, driveway or paving permit. If the work touches the drive approach, curb or gutter in the right-of-way you also need an approach permit displayed on site, and applications get 10 business days for city review before anything can be issued. On new single-family construction the flatwork permit is included in the house permit.

How long before I can drive on a new concrete driveway?

Foot traffic comes first, vehicles considerably later, and heavy vehicles later still. The 28-day compressive strength quoted on specifications is a test age rather than a waiting period, and the practical dates move with the mix and the weather that week. We set and hand you the three dates on the day of the pour.

Why do new driveways crack, and can that be prevented?

Concrete shrinks as it cures and moves with the ground beneath it, so cracking is managed rather than prevented. Control joints cut at the right spacing give that movement a place to go, isolation joints stop the slab binding against the garage and the approach, and proper subgrade preparation removes the differential support that causes the cracks nobody planned for.

What happens if the excavation hits rock?

On the chalk side of the city that is a real possibility, with paralithic bedrock at a representative 20 centimeters under Eddy soils and 74 centimeters under Austin. Rock excavation is labor rather than material, so it changes the price meaningfully. We assess likely depth to refusal before quoting so it appears in the original number instead of as a change order.

Can a driveway be widened or extended later?

It can, and it always shows. New concrete against old leaves a cold joint that will not knit, and the new pour starts lighter and never quite matches the weathered surface beside it. If a wider drive, a turnaround or an RV pad is likely within a few years, it is worth building the footprint now.

Is a stamped driveway much more expensive than a plain one?

Less than most people expect, because excavation, base, reinforcement, thickness and the concrete itself are the same for both. The premium covers stamping labor, color, release agent and sealing. The gap is proportionally wider on small pours, where setup time dominates the bill regardless of finish.
